Purchase Order Automation for Procurement and Finance

Purchase Order Automation for Procurement and Finance Purchase order automation is the software-driven process that replaces manual PO creation, approval routing, and invoice reconciliation with a programmatic workflow that enforces controls automatically, from the moment a pu...

Jaxon Avery
Jaxon Avery
23 min read
Purchase Order Automation for Procurement and Finance primary image

Purchase Order Automation for Procurement and Finance

Purchase order automation is the software-driven process that replaces manual PO creation, approval routing, and invoice reconciliation with a programmatic workflow that enforces controls automatically, from the moment a purchase request is submitted through three-way match and payment release. According to Sage’s guide to purchase order automation, implementation should begin with mapping your current PO lifecycle and standardizing policy before touching any software configuration.

Start here:

  • Stakeholder map: Identify every person who initiates, approves, or receives purchases today, including those working outside your official system.

  • Top 3 KPIs from day one: PO cycle time, invoice-to-PO match rate, and maverick spend percentage.

  • Pilot scope: Pick one high-volume, low-complexity spend category and one ERP integration as your first 90-day target.

Key Takeaways

Purchase order automation delivers measurable ROI only when policy standardization, integration architecture, and change management are treated as equal priorities alongside the software itself.

Point Details
Standardize policy first Clean vendor data and documented approval thresholds must exist before any workflow is configured.
Pilot with one integration A 90-day pilot scoped to one spend category and one ERP connector limits risk and proves value fast.
Track straight-through rate The touchless processing rate is the single best indicator of automation health after go-live.
Budget for hidden costs Integration engineering, data cleanup, and vendor onboarding routinely exceed initial estimates by 20–30%.
Treat it as a culture change Enforcing PO-based approvals over email requires active change management, not just software deployment.

Table of Contents

Why purchase order automation matters to procurement and finance

The business case for an automated purchase order system is not abstract. It shows up in measurable reductions across three operational dimensions: speed, accuracy, and control.

Speed. Manual approval chains routed through email routinely add days to a PO cycle. Automated routing sends requests to the right approver instantly, escalates on schedule, and logs every action. Procurement teams that remove email-based approvals from the critical path typically see approval times drop from days to hours.

Accuracy and cost. Every manually keyed PO is a data-entry risk. Duplicate orders, wrong vendor IDs, and mismatched quantities all create downstream reconciliation work in accounts payable. PO matching automation using 2-way and 3-way logic with configurable tolerances catches those discrepancies before they become payment disputes, reducing cost-per-PO and AP labor hours.

Compliance and control. Automated workflows enforce budget thresholds, preferred-vendor policies, and approval hierarchies consistently, without relying on individual employees to remember the rules. Every action is timestamped and logged, giving finance and audit teams a clean, queryable trail.

Visibility. A single source of truth for open POs, received goods, and pending invoices lets procurement and finance report on committed spend in real time rather than reconstructing it from spreadsheets at month-end.

The stakeholder benefits map cleanly: procurement saves on vendor negotiations through better spend data, AP reduces manual reconciliation hours, and finance gains the reporting accuracy needed for reliable forecasting. APQC’s procurement benchmarks show wide variance in PO cycle time and cost-per-order across organizations, which means there is almost always a measurable improvement window available.

What breaks in manual PO workflows

Most procurement teams know their process has problems. The harder question is which problems are costing the most.

Maverick spend is usually the biggest dollar leak. When employees bypass the PO system because it is slow or inconvenient, purchases happen outside negotiated contracts and without budget controls. Shadow purchasing is not a discipline problem; it is a process design problem. If the official channel is harder than a credit card, people will use the credit card.

Email-based approvals create invisible bottlenecks. Requests sit in inboxes, get forwarded to the wrong person, or simply disappear. There is no audit trail, no escalation trigger, and no way to measure how long approvals actually take. Corpay’s guidance on PO automation is direct on this point: successful automation requires treating POs as the single gatekeeper for purchases, not email threads.

Invoice-to-PO mismatches are the downstream consequence of upstream data problems. A PO with the wrong unit price, a missing line item, or an unrecorded partial receipt generates an exception that someone in AP has to resolve manually. High exception rates are a reliable signal that your PO data quality needs attention before you add more automation.

Pro Tip: Before you evaluate any purchase order management software, spend two weeks logging every purchase that happened outside your PO system. The dollar value of that shadow spend is your most persuasive internal business case.

Inconsistent vendor master data compounds all of these issues. Duplicate vendor records, outdated payment terms, and missing tax IDs create matching failures and compliance gaps that no amount of automation can fix if the underlying data is not clean.

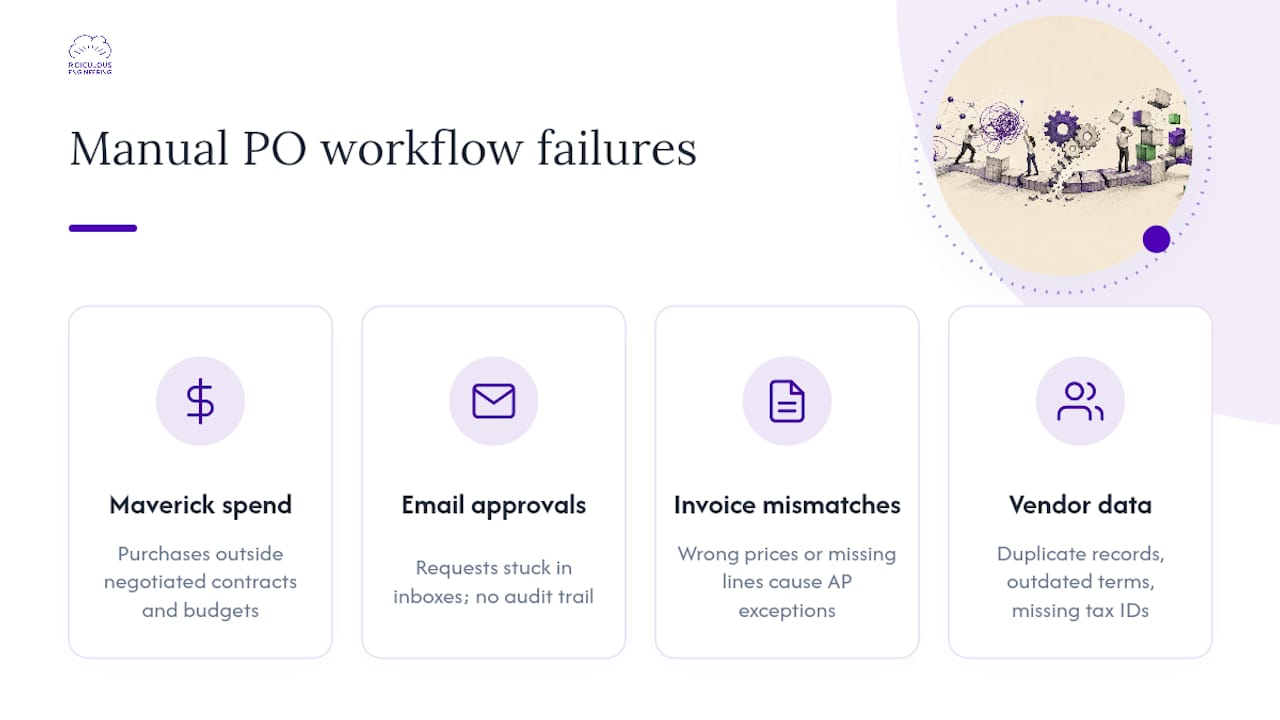

What breaks in manual PO workflows — overview diagram

How to implement purchase order automation step by step

A practical rollout follows a clear sequence. Skipping steps, particularly the policy and data work at the front, is the most common reason implementations stall at 60% adoption. Amazon Business’s PO automation overview confirms this five-stage pattern as the foundation for a working rollout.

  1. Map existing processes. Document every path a purchase request can take today, including informal ones. Identify who approves what, at what dollar thresholds, and in which systems. Shadow purchasing patterns belong on this map.

  2. Define policy standards. Establish preferred vendor lists, approval thresholds by department and spend category, and budget controls before configuring any workflow. Automating a fractured policy just makes the wrong thing happen faster.

  3. Design approval workflows and exception rules. Configure approval chains, delegation rules, and tolerance bands for matching. Decide what triggers an exception versus a straight-through approval.

  4. Choose integrations and map data fields. Connect your PO system to your ERP, AP platform, and supplier network. Map PO number, vendor ID, line-item codes, GL accounts, department codes, and receipt data at this stage.

  5. Run a 90-day pilot. Select one spend category, define acceptance criteria (match rate target, cycle time target, exception rate ceiling), and build a rollback plan before go-live.

  6. Scale and optimize. Add vendor onboarding, punchout catalogs, and additional spend categories. Institute monthly KPI reviews and refine tolerance thresholds based on real exception data.

Implementation checklist:

  • Process maps signed off by procurement, AP, and finance

  • Vendor master data cleaned and deduplicated

  • Approval matrix documented and approved by department heads

  • Integration test plan with sample data sets covering edge cases

  • Training materials completed for approvers and requestors

  • Pilot acceptance criteria defined in writing before go-live

  • Rollback plan documented and communicated to stakeholders

Pro Tip: Audit your policy first, not your software. If your approval thresholds are inconsistent or your vendor list has not been reviewed in two years, standardize those before your final automation configuration. Automating bad policy at scale is significantly harder to unwind than fixing it on paper.

How to choose PO automation software

Vendor selection for purchase order workflow automation comes down to five evaluation axes, and integration capability should rank first.

Integration and APIs. A system that cannot connect cleanly to your ERP, AP platform, and banking infrastructure will require manual workarounds that defeat the purpose. Prioritize vendors with prebuilt connectors for your specific ERP version and open APIs for anything custom. Sage’s procurement software guidance recommends evaluating prebuilt integrations, open APIs, configurable workflows, audit logging, and reporting as the core capability checklist.

Matching features. Confirm whether the system supports 2-way matching (PO to invoice), 3-way matching (PO, receipt, and invoice), and line-level matching. Configurable tolerance thresholds and intelligent exception routing, as described in Yooz’s line-level matching documentation, can materially increase straight-through processing rates when trained on real invoice samples.

Security and compliance. Look for role-based access controls, full audit trails, data encryption at rest and in transit, and SOC 2 Type II certification. Procurement workflows are a known target for business email compromise and vendor impersonation attacks, per the Cloud Security Alliance’s BEC/VEC advisory, so vendor authentication controls are not optional.

Usability. Low-code workflow editors, mobile approval interfaces, and vendor punchout catalogs reduce training time and improve adoption. If approvers need IT help to delegate approvals when they travel, the system will create bottlenecks.

Pricing and hidden costs. Per-PO, per-user, and subscription models each have different cost profiles at scale. Budget separately for integration engineering, vendor onboarding, IDP/OCR setup, and ongoing support. These line items are frequently underestimated.

Negotiation tips:

  • Require a defined SLA for uptime (99.5% minimum) and support response times in the contract.

  • Tie onboarding milestone payments to delivered functionality, not calendar dates.

  • Confirm data export and portability terms before signing; you need to own your PO and transaction history.

Pro Tip: Ask every vendor for a reference customer running your ERP version. A connector that works for NetSuite may behave very differently against a heavily customized SAP instance. Verify before you commit.

For teams evaluating workflow automation tools more broadly, the same integration-first evaluation framework applies.

Integrating PO automation with your ERP, AP systems, and supplier network

Integration architecture is where most PO automation projects encounter their first real friction. Three patterns cover most scenarios.

Direct connector uses a vendor-built, point-to-point integration with your ERP. Fast to deploy when the connector exists and your ERP version is supported. Brittle when your ERP is heavily customized or on an older release.

iPaaS/middleware (platforms like MuleSoft, Boomi, or Azure Integration Services) sits between systems and handles transformation, routing, and error handling. More flexible and easier to maintain across multiple integrations, but adds licensing cost and requires integration engineering expertise.

Flat-file sync uses scheduled CSV or EDI file exchanges. Low technical barrier, but near-real-time visibility is impossible and reconciliation gaps are common. Acceptable only for low-volume or transitional scenarios.

Key fields to map in every integration:

  • PO number (unique, system-generated)

  • Vendor ID (matched to cleaned vendor master)

  • Item codes or SKUs, quantities, and unit price

  • GL account and department/cost center codes

  • Receipt data: quantity received, receipt date, and receiving location

  • Invoice number and payment terms

Three-way match requires that receipt data flows into the matching engine in real time or near-real time. RF-based warehouse systems, advance ship notices (ASNs), and manual receiving entries all feed this process differently, and each needs a tested data path.

Integration testing checklist:

  • Full PO lifecycle with a clean, matched invoice

  • Partial delivery against a multi-line PO

  • Multi-PO invoice (one invoice referencing two POs)

  • Price variance within tolerance and outside tolerance

  • Duplicate invoice submission

  • Vendor ID not found in master data

Backfilling historical PO records into a new system is often underestimated. Decide early whether you need full history or a clean cutover date, because backfill work can add weeks to a timeline.

The KPIs to track and how to measure PO automation success

Measuring the right metrics from day one prevents the common situation where a team deploys automation and then cannot demonstrate its value to finance leadership six months later. Aligning these metrics with your FP&A reporting framework from the start makes budget justification straightforward.

Primary KPIs:

  • PO cycle time: Time from purchase request submission to approved PO sent to vendor. Measure in business hours, not calendar days.

  • Approval time: Time from PO submission to final approval. Isolates bottlenecks in the approval chain.

  • Touchless (straight-through) rate: Percentage of POs processed without any manual intervention. This is your headline automation efficiency metric.

  • Invoice-to-PO match rate: Percentage of invoices that match automatically on first pass. Low match rates signal data quality or policy problems.

  • Cost per PO: Total AP and procurement labor cost divided by PO volume. Tracks efficiency gains over time.

  • Maverick spend percentage: Purchases made outside the PO system as a share of total spend. Should decline steadily after go-live.

APQC benchmarks show wide performance variance across organizations, so set your initial targets against your own baseline rather than industry averages. Aim for measurable improvement windows, not best-in-class metrics in month one.

Measure weekly during the pilot, monthly after stabilization. Source data from your ERP, AP system, and PO automation logs. Alert thresholds worth acting on immediately: match rate drops below your pilot baseline, maverick spend increases month-over-month, or approval time exceeds your defined SLA.

Typical implementation timeline and the cost drivers you must budget for

Phase Activities Typical Duration
Discovery Process mapping, stakeholder interviews, policy review 2–3 weeks
Configuration Workflow design, approval rules, tolerance setup 2–4 weeks
Integration ERP/AP connectors, field mapping, data migration 3–6 weeks
Pilot 90-day live test with one spend category 10–12 weeks
Training and change management User training, documentation, adoption tracking 2–3 weeks (overlaps pilot)
Scale Additional categories, vendor onboarding, optimization Ongoing

Total time from kickoff to a stable, scaled deployment typically runs 5–9 months for mid-market organizations. Enterprise deployments with complex ERP customizations or multi-entity structures can run longer.

Primary cost drivers to budget explicitly:

  • Software licensing (per-PO, per-user, or subscription)

  • Integration engineering for ERP and AP connectors

  • IDP/OCR setup and training for invoice capture

  • Vendor onboarding and punchout catalog configuration

  • User training and change management

  • Ongoing support and system administration

Budget a contingency of 20–30% for custom connector work and data cleanup. Vendor onboarding almost always takes longer than estimated, particularly for suppliers with non-standard invoice formats. ROI timelines are most reliably estimated by multiplying your current cost-per-PO by projected volume, then subtracting the post-automation cost-per-PO. Cycle-time reductions also free up AP staff hours that can be redeployed to higher-value work.

Practical best practices to maximize PO automation success

The teams that get the most out of their automated purchase order systems share a few consistent habits.

  • Require PO numbers at checkout for all common suppliers before go-live. Vendors who accept orders without a PO number are the primary enabler of maverick spend.

  • Start with high-volume, low-complexity categories. Office supplies, recurring services, and standard MRO items give you fast cycle times and clean data, which builds confidence and demonstrates ROI quickly.

  • Set tolerance thresholds conservatively at first. A 1% price tolerance and a zero-quantity-variance rule will generate more exceptions initially, but the exception data tells you where your real problems are. Loosen thresholds only after analyzing patterns.

  • Assign a named owner for recurring exceptions. Unresolved exceptions that sit in a queue for weeks are a sign that your exception workflow needs a responsible party, not more automation.

  • Review approval rules quarterly. Org changes, new vendors, and budget resets all affect whether your configured rules still reflect reality.

Pro Tip: Catalog integrations and punchout connections to common suppliers, as supported by platforms like ProcureDesk, pre-populate item codes, pricing, and vendor data directly into the PO. This eliminates a large share of manual entry errors before matching even runs.

When should you build custom PO automation vs buy a commercial product?

Most organizations should start with a commercial purchase order management platform. The build-vs-buy decision shifts when your workflows are genuinely unusual, your legacy systems resist standard connectors, or your regulatory environment requires controls that off-the-shelf products cannot configure.

Dimension Commercial product Custom build
Time to value Faster (weeks to months) Slower (months to a year+)
Upfront cost Lower licensing; higher integration cost Higher engineering cost
Customization Limited to vendor roadmap Full control
Maintenance Vendor-managed updates Internal or partner-managed
Security control Vendor-defined; SOC 2 certification common Configurable to your exact requirements
Legacy ERP fit Depends on connector availability Can be engineered to fit any system

Custom engineering makes sense when you have a proprietary vendor catalog that no commercial connector supports, when your ERP is heavily customized and connectors break on every update, or when your industry has compliance requirements that commercial products handle poorly. The build-vs-buy decision framework is worth working through explicitly before committing to either path.

The operational question that often gets skipped: who owns the system after launch? A commercial product has a vendor support team. A custom build needs an internal owner or a long-term engineering partner. Budget and staff accordingly.

A 90-day pilot plan and checklist to get started now

A focused pilot is the fastest way to prove value and secure budget for a full rollout. Keep the scope tight.

90-day pilot milestones:

  1. Weeks 1–2: Finalize process maps, clean vendor master data for pilot category, confirm stakeholder list and approval matrix.

  2. Weeks 3–4: Configure approval workflows and tolerance rules, complete ERP integration for pilot category, load sample PO and invoice data.

  3. Weeks 5–6: Run integration tests against all edge-case scenarios, resolve data mapping issues, complete user training for pilot group.

  4. Weeks 7–10: Go live with pilot category. Track KPIs weekly. Log every exception and its resolution time.

  5. Weeks 11–12: Review pilot KPIs against acceptance criteria. Document lessons learned. Present go/no-go recommendation to stakeholders.

Pilot checklist:

  • Pilot spend category selected and scoped

  • Vendor master data cleaned for pilot vendors

  • Approval matrix documented and signed off

  • Integration tested with edge-case data sets

  • Training completed for all pilot users

  • KPI baseline established before go-live

  • Rollback plan documented (revert to manual process if match rate falls below threshold)

  • Exception escalation path assigned to a named owner

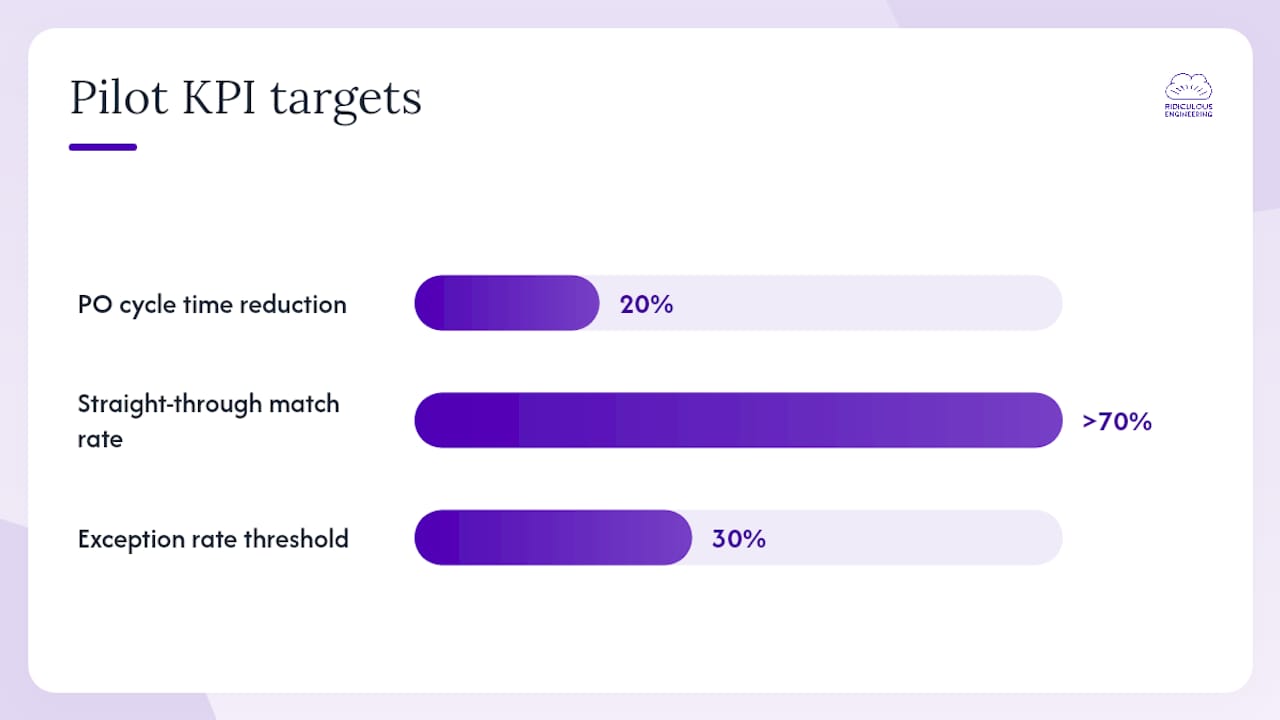

Pilot KPI targets: Set your own baseline in week one, then target a 20% reduction in PO cycle time and a straight-through match rate above 70% by week ten. If exceptions exceed 30% of processed POs in weeks 7–8, trigger the escalation review before proceeding to scale.


A 90-day pilot plan and checklist to get started now — overview diagram

Ridiculous Engineering builds and integrates custom procurement and workflow automation systems for organizations whose requirements outgrow off-the-shelf products. If your ERP is heavily customized, your vendor catalog is proprietary, or you need an integration that no commercial connector supports, our team can engineer a solution that fits the way your organization actually operates. See our custom software development services to learn how we approach these engagements.

Sources

FAQ

What is purchase order automation?

Purchase order automation is the software-driven process that handles PO creation, approval routing, distribution, and invoice matching automatically, replacing manual steps with programmatic controls tied to your ERP and AP systems.

How long does a PO automation implementation take?

Most mid-market implementations run 5–9 months from kickoff to stable, scaled deployment, with a focused 90-day pilot as the recommended first phase before broader rollout.

What is three-way matching in PO automation?

Three-way matching compares the purchase order, the goods receipt, and the vendor invoice to confirm that quantity, price, and terms align before releasing payment, reducing manual reconciliation and fraud risk.

How do you measure PO automation success?

Track PO cycle time, touchless (straight-through) processing rate, invoice-to-PO match rate, cost per PO, and maverick spend percentage, measured weekly during the pilot and monthly after stabilization.

When does custom PO automation make more sense than a commercial product?

Custom engineering is the right call when your ERP is heavily customized and standard connectors break, your vendor catalog is proprietary, or your compliance requirements exceed what commercial platforms can configure.

An image of an office space with a digital fingerprint illustration floating over it, with the words data, source, and code .
Analytics

Article

Data-Fueled Governance: Transforming Public Services with Shared Data

This article explores the growing importance of data-driven governance in today's digital society, particularly in the context of the COVID-19 pandemic. It discusses the key drivers behind data-fueled governance, including AI and cloud technology adoption, the role of Chief Data Officers (CDOs), and the balance between data utilization and ethical considerations. The article highlights successful case studies and provides strategies for governments to enhance their data-driven approaches, emphasizing the importance of maintaining data technology, developing proactive data policies, and supporting the role of CDOs.

Ridiculous EngineeringJun 30, 2024

Embrace Technology with Confidence

Your Guide to Successful Technology Adoption

If you are looking for a guide in adopting technology, a technology switch, or how to best apply new technology in your business, we at Ridiculous Engineering are here for you. Reach out today to learn how we can help.
